Bathroom remodel cost in Tulsa, OK
What a bathroom remodel really costs in Tulsa, and how to budget for it
- Cost and Budgeting
If you have searched for what a bathroom remodel costs in Tulsa, you have probably found numbers that start near $4,500 and climb past $65,000. Both can be true. “Bathroom remodel” describes at least four very different jobs, and most of the price difference comes from which one you are actually doing.
This guide breaks the cost down the way a contractor does, shows what moves the number most in Tulsa homes, and gives you a budget worksheet and a quote checklist you can use whether you hire us or anyone else.
How much does a bathroom remodel cost in Tulsa?
Published Tulsa estimates fall into three bands. Block Renovation’s Tulsa guide lists cosmetic updates at $4,500 to $12,000, mid-level renovations at $12,000 to $28,000, and major overhauls at $30,000 to $65,000 or more. HomeAdvisor’s Tulsa page reports an average of $10,513 with a typical range of $6,643 to $15,259.
Treat those as brackets, not quotes. Both sites make money connecting homeowners with contractors, the data is self-reported, and neither knows whether your bathroom has a slab floor, a 1960s cast iron drain or a window that has been leaking for years.
A more useful way to think about it is by what actually changes in the room:
| Job | What changes | What drives the price | Fits you if |
|---|---|---|---|
| Refresh | Vanity, toilet, faucets, lighting, paint, maybe flooring. Everything stays where it is. | Vanity quality, flooring, fixture finishes | The layout works and the room just looks tired |
| Surface replacement | New tile, tub-to-shower conversion, new shower walls (tile, or acrylic or solid-surface panels) or enclosure. Plumbing stays roughly in place. | Tile or panel choice, tile area and pattern, waterproofing, glass, labor hours | The tub or shower is the problem |
| Full remodel | Down to the studs: new floor, walls, plumbing, electrical, ventilation, finishes | Everything above, plus what is found behind the walls | The room is worn out, damaged or poorly built |
| Layout or accessibility change | Moved toilet, tub or drain, curbless shower, widened door, blocking for grab bars | Plumbing and framing changes, sometimes concrete work | Someone needs the room to work differently, or you want a bigger room |

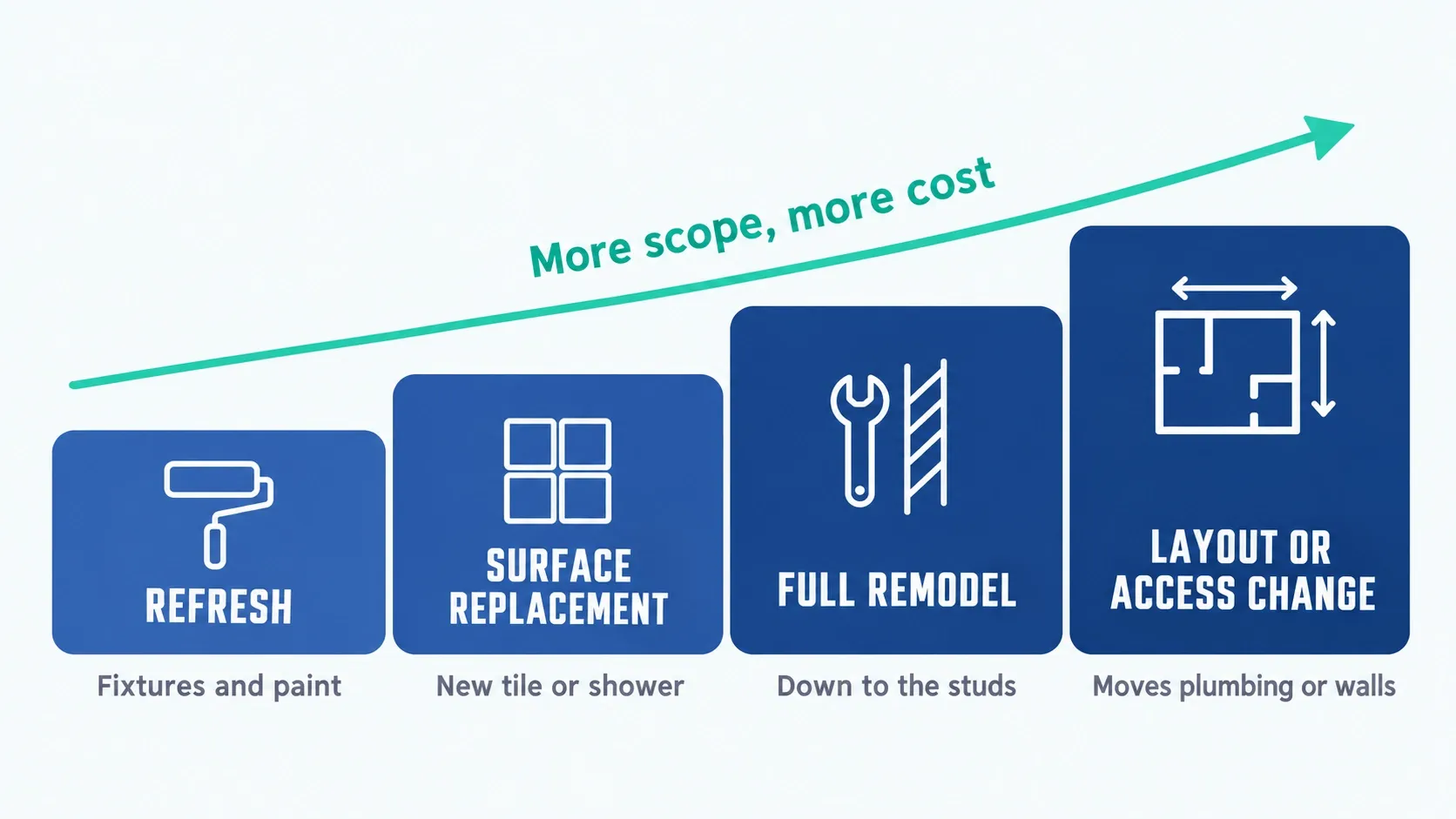

The four kinds of bathroom remodel. Each step up adds scope, and cost follows.
The average cost of a bathroom remodel hides what matters
An average blends a hall bath refresh with a primary suite remodel, so no single homeowner pays the average. Instead of asking what the average is, ask which of these cost drivers apply to your bathroom. These are the line items that most often move a bathroom budget:
- Moving plumbing. Relocating a toilet, shower or tub means new drain and vent runs. In a house on a slab foundation, that can mean cutting and patching concrete. Block’s Tulsa guide notes the same point for slab homes.
- Tile or panels. Tile is labor-heavy. Floor area, shower wall height, small mosaics, herringbone and other patterns all add hours, and the waterproofing under the tile matters more than the tile itself. Acrylic or solid-surface wall panels, or a one-day shower kit, usually go up faster than tile and are a sound choice for many showers; tile gives you more patterns and layouts. We install all of them.
- What is behind the wall. Older Tulsa bungalows and ranch homes can hide galvanized supply lines, undersized drains, soft subfloors and framing that is no longer square. You cannot price these until the room is opened up, which is why a contingency fund exists.
- Tub-to-shower conversions. The demolition is straightforward, but the new shower needs a properly sloped, waterproofed floor and often a new drain position.
- Shower glass. Frameless glass is measured after the tile is finished and then made to order. It is a real cost and it affects the schedule.
- Vanity and counters. Stock, semi-custom and custom vanities can differ by thousands of dollars for the same footprint.
- Accessibility work. A curbless entry, a wider doorway or solid blocking for grab bars adds framing and floor work. It is much cheaper to plan this during a remodel than to retrofit it later.
- Electrical and ventilation. GFCI protection, updated lighting and, if the job includes one, a new exhaust fan are not glamorous line items, but they belong in the price.
Build your own bathroom remodel budget
Use this worksheet before you call anyone. It takes about twenty minutes and makes every quote easier to compare.
- Pick your job from the table above. If you are between two tiers, price both.
- Sort wants into must-have and nice-to-have. A walk-in shower you will actually use for twenty years is a must-have. A heated floor might not be.
- List what you will buy yourself. If you plan to supply the vanity, faucets, mirrors or tile, those are your costs, not the contractor’s. Ask the contractor what they expect you to supply and by when.
- Add costs outside the contract. Permit fees if your job needs a permit, a design fee if you use a designer, and a plan for where your family will bathe while the room is out of service.
- Add a contingency of 10 to 20 percent. Use the high end for a house built before 1980 or any project that opens walls or floors. If you do not spend it, you keep it.
- Decide how you will pay. Savings, a home equity loan or line of credit, a personal loan and contractor financing all work for some households. Compare the total cost of borrowing, not just the monthly payment.

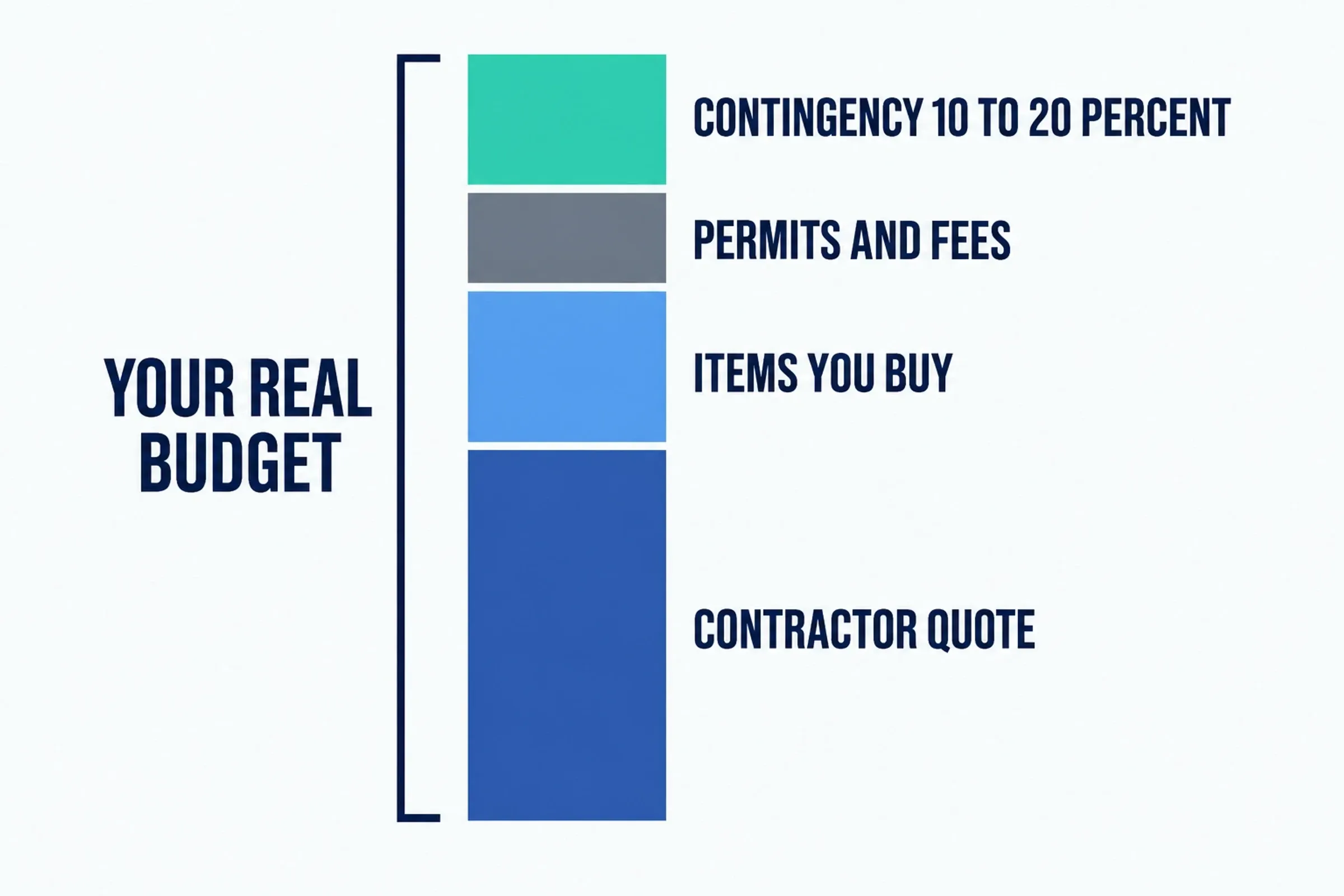

Your real budget is more than the contractor quote.
How to read a bathroom remodel quote
Two quotes for the “same” bathroom can be $6,000 apart because they are not actually the same job. Look for these line items, and ask about any that are missing:
- Demolition, haul-away and protection of floors and adjoining rooms
- Plumbing: rough-in and finish, and whether the plumber is licensed
- Waterproofing: the named system under the tile, not just “waterproofing”
- Tile: square footage, the material allowance per square foot, and who selects it
- Vanity, top, faucet and mirror: included, or an allowance you will pay the difference on
- Electrical and ventilation: GFCI protection, lighting, and the exhaust fan if the job includes one
- Permits: whether your job needs one and, if so, who handles it
- Change orders: how extra work gets priced and approved in writing
- Payment schedule, warranty and cleanup
Red flags: a single lump sum with no breakdown, a “tile allowance” so low you could never buy the tile you were shown, no word on whether the job needs a permit, and a large deposit before any materials are ordered.
Do you need a permit for a bathroom remodel in Tulsa?
It depends on the work and where your home is. Oklahoma state law does not necessarily require a permit for a bathroom remodel, but cities set their own rules: the City of Tulsa’s Development Services office says a project may require building, electrical, mechanical or plumbing permits depending on its scope. You can start with the Development Services plan review page or call (918) 596-9456.
Oklahoma licenses plumbers through the Construction Industries Board. Ask any contractor who does the plumbing and the electrical work on your job. Unpermitted work can lead to stop-work orders, and it can complicate a sale later when an inspector or buyer asks for records.
Whether your job needs a permit is something we talk through with you at the estimate, and the City has the final word for your address.
Older Tulsa homes: what turns up behind the walls
Plan for the usual older-house findings: galvanized supply pipes, small or corroded drains, soft subfloor around the tub or toilet, and rotten studs where a shower has leaked for years. None of it can be priced until the room is open. When the wall is open, we update the plumbing to current standards and code, and if something we find changes the price, you hear about it and approve it in writing before we do the extra work.
Bathroom remodel timeline in Tulsa
How long a remodel takes depends on the scope, but the order of work is the same, and knowing it helps you read a schedule:
- Planning and ordering. Vanities, specialty tile and fixtures can have lead times. Confirm them before demolition, not after.
- Demolition.
- Rough plumbing and electrical. This is where inspections happen if permits apply.
- Waterproofing and tile. Waterproofing membranes and tile setting materials need cure time.
- Glass. Custom glass is templated after tile is done and then fabricated, often adding a week or two.
- Fixtures, vanity and finish work.
- Final walk-through and cleanup, with a final inspection if the job has a permit.

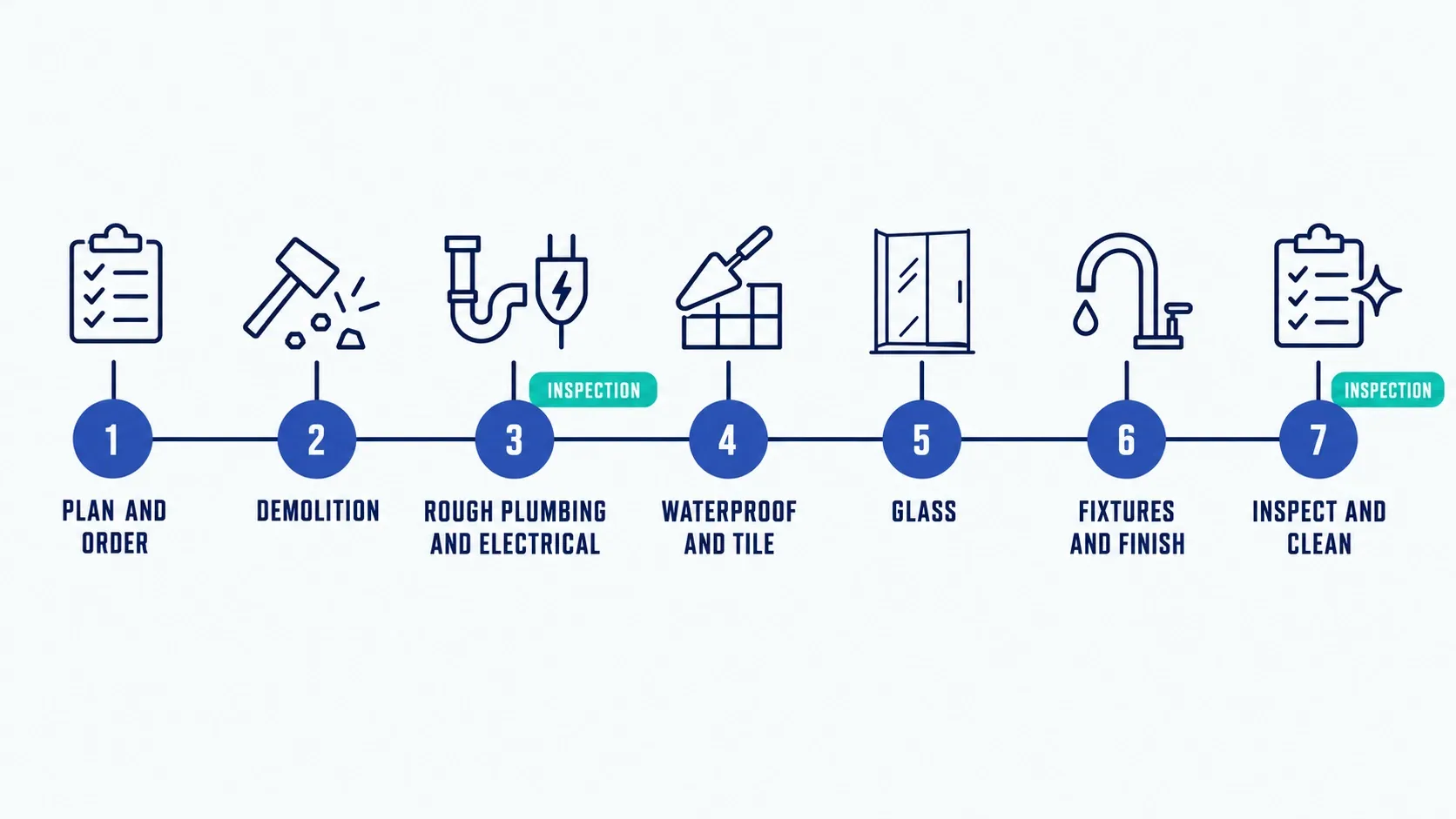

The usual order of work. Inspections happen where permits apply.
A full remodel usually runs about a week, and up to two weeks when the room is larger or the tile is intricate. You should get a written schedule before work starts.
Bathroom remodel financing in Tulsa
Financing is a tool, not a cost reduction. The common options:
- Cash or savings. No interest, but do not drain your emergency fund.
- Home equity loan or line of credit. Usually lower rates than unsecured loans, but your home secures the debt.
- Personal loan. Faster and unsecured, often with higher rates.
- Contractor financing. Some remodelers offer it. Worth comparing against the others, and read the terms on promotional rates, including what happens if the balance is not paid off in time.
We do not finance in house. Homeowners who spread the cost usually go to a local lender, and Tulsa Teachers Credit Union, Arvest and Regent Bank all handle projects like this. What they ask to see is an itemized written quote, which is what we give you. If the project is a safety upgrade for a veteran, see how the VA’s benefit works before you borrow. Whatever you choose, ask for the interest rate, the term and the total amount you will repay.
What happens at a free estimate
We come to your home at no cost, look at the bathroom, take measurements, and talk through what is possible and what we would not recommend, with no obligation. The materials are your choice: we will tell you what we recommend, you are welcome to buy some of them yourself, and if you want to see options in person we send clients to trade showrooms such as ProSource and Emser Tile. Your itemized written quote follows in 1 to 2 days, so you can compare it against any other quote on the worksheet above.
If you are already weighing a specific project, these pages explain the details: bathroom remodeling, walk-in showers, tub to shower conversion and tub and fixture replacement. To see what real jobs cost, our project case studies give rounded ranges from signed quotes, from a walk-in shower in Bixby to a master bath remodel in east Tulsa, and our Tulsa page explains what each era of Tulsa housing tends to leave behind the walls. When you are ready, request a free estimate or contact us.
